How Long Does It Take to Build a Custom Home in the Pacific Northwest?

About WordPress

Search this question online, and you’ll get an answer that sounds reassuring and doesn’t apply to you. Most of the numbers floating around the internet describe spec homes, the kind a developer builds on speculation and lists for sale once it’s finished. That is not what happens when you build a custom home on your own land in Washington or Oregon, and the timeline looks different because the process actually is different.

According to 2024 Census Bureau Survey of Construction data analyzed by the National Association of Home Builders, homes built by a hired contractor took about 12 months from authorization to completion, while owner-built homes took even longer at 15.1 months. Spec homes built for sale, by comparison, were finished in about 7.6 months.

If you searched “how long to build a house” and landed on a number closer to seven or eight months, that figure almost certainly reflects a spec-built subdivision home, not a custom build on land you already own.

Why Your Timeline Looks Different From a Spec Home’s

A spec builder is working from a plan they have built dozens of times, on a lot they already control, with permits often secured in batches before construction starts. A custom on-your-lot build starts from a different point entirely. Your land needs its own site evaluation. Your plan gets customized to your preferences. Your permits are pulled individually for your specific parcel, not as part of a subdivision-wide batch.

Every one of those differences adds real time, and every one of them exists because you are getting a home built specifically for you rather than one built for whoever happens to buy it.

That is the real reason the contractor-built timeline of around 12 months is the more honest benchmark for anyone planning a custom home in the Pacific Northwest, rather than the faster spec-home number that tends to dominate search results.

The Stages That Make Up a PNW Custom Build

A custom build breaks down into a sequence of stages, and understanding where the time actually goes helps set realistic expectations from day one.

Land feasibility and site preparation come first, and this stage varies more in Washington and Oregon than almost anywhere else in the country. Soil conditions, well and septic requirements, and access road grading all need to be assessed before a shovel goes into the ground, and rural parcels often need more of this work than a lot inside city limits. A parcel with straightforward access and existing utility hookups might clear this stage in a few weeks, while a heavily wooded or sloped lot can take considerably longer to evaluate and prepare.

Design and permitting follow, and this is where customization adds real time compared to a spec home. Your floor plan gets finalized, engineering gets confirmed for your specific site conditions, and permits get submitted to your local jurisdiction. Permitting timelines vary significantly by county and can be one of the least predictable parts of the entire schedule, since two neighboring counties can have noticeably different review times for what is otherwise a similar plan.

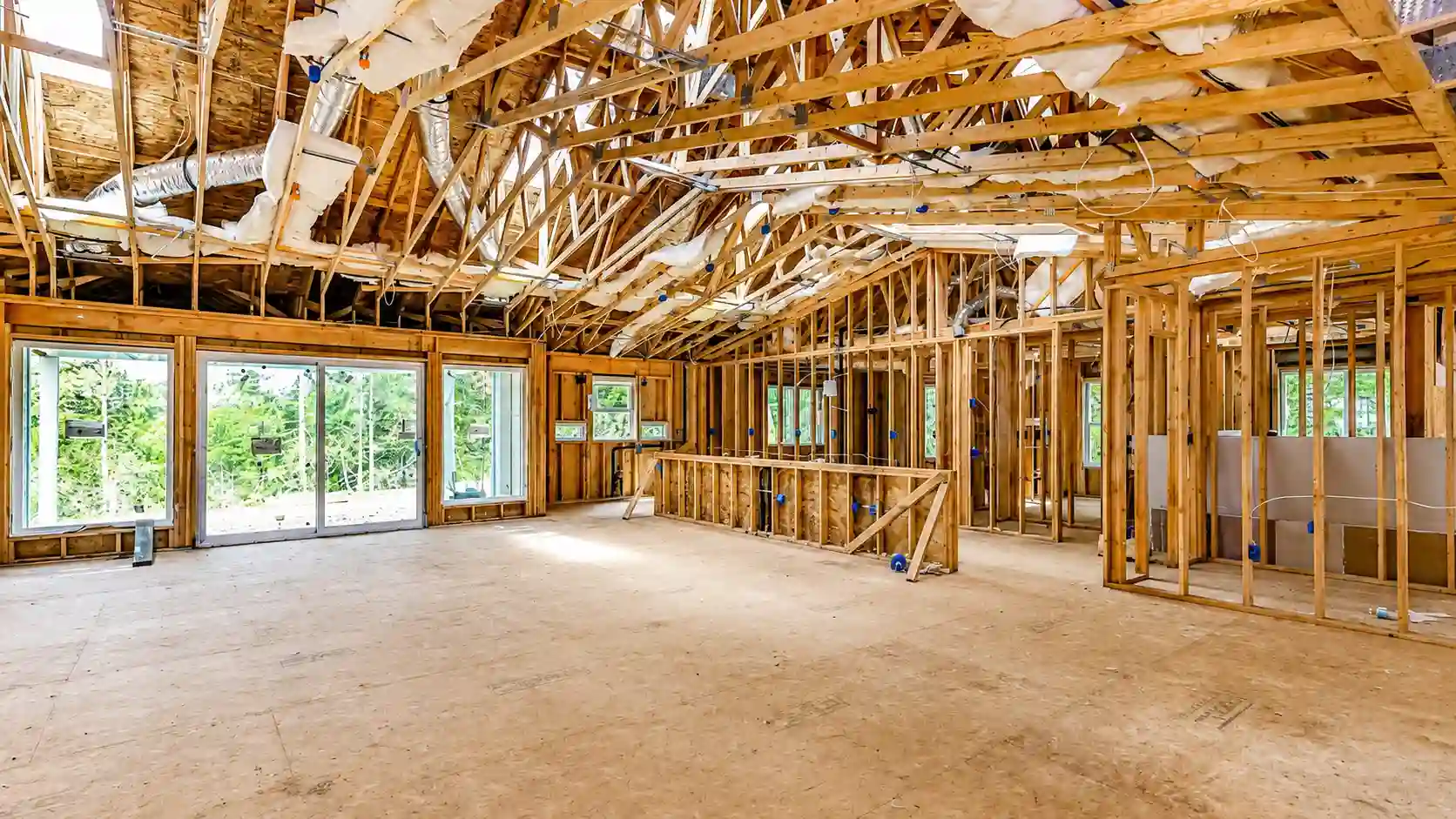

Foundation and framing come next, followed by the mechanical rough-ins for electrical, plumbing, and HVAC. This is typically the stage where a build starts to feel real, since the structure is visibly taking shape, and it also tends to move at a fairly predictable pace once permits are in hand and weather cooperates.

Interior finishes, from drywall through cabinetry, flooring, and fixtures, make up the final stretch before a final inspection clears the home for occupancy.

What Actually Stretches a Timeline in the Pacific Northwest

Weather is the factor most people underestimate. Washington and Oregon both have a wet season that can slow site work, foundation pours, and exterior work for weeks at a time, and building on a schedule that ignores this reality is one of the most common ways a timeline slips. A foundation pour scheduled for the middle of a wet Willamette Valley winter, for example, is a very different proposition than the same pour scheduled for a dry August.

Rural land presents its own set of variables. A parcel without existing utility access needs well and septic work planned and permitted before the home itself can move forward, and that process runs on its own timeline, separate from the home’s construction schedule. Septic approval in particular can involve its own site evaluation and county sign-off well before the home’s building permit is even submitted.

Permitting is the third major variable, and it is also the one most within a builder’s control to manage well. Working with a team that has an established relationship with local building departments and understands each jurisdiction’s specific requirements tends to move through this stage more predictably than working with a builder unfamiliar with the area.

How to Keep Your Build on Schedule

The buyers who end up happiest with their timeline are the ones who treat the front end of the process, land feasibility and design, as seriously as the construction phase itself. Rushing through site evaluation to get to the exciting part of watching a home take shape often creates delays later, when an unanticipated site issue surfaces mid-build instead of getting caught during planning.

Setting a realistic schedule at the outset, one that accounts for your land’s specific conditions rather than a generic national average, is the single best predictor of a build that finishes on time.

Building Custom Homes Across the Salem, Oregon Area

True Built Home has been building custom, stick-framed homes on customers’ own land throughout Washington and Western Oregon since 2008, and our Salem branch works with families building throughout Marion County and the surrounding Willamette Valley.

We understand the specific permitting and site conditions that come with building in this region, from rural parcels needing well and septic work to lots within Salem city limits with their own set of local requirements.

Our Home Building Process page walks through each stage of a True Built Home construction timeline in detail, and for anyone still evaluating whether their land is build-ready, our Land Feasibility Resources page covers what that evaluation actually involves before construction begins.

Ready to Get a Realistic Timeline for Your Land

The only way to know how long your specific build will take is to have your land and plan evaluated by a team that builds in your region regularly. Reach out to our team and we will walk through your site, your plan, and a realistic schedule built around your actual land instead of a generic number pulled from an unrelated spec-home development.

Like this article?

Share on Facebook
Share on Twitter
Share on Pinterest
Share via Email

Contact Us To Build

Search
We'll Be In Touch!
We received your message. One of our team members will contact you soon.
